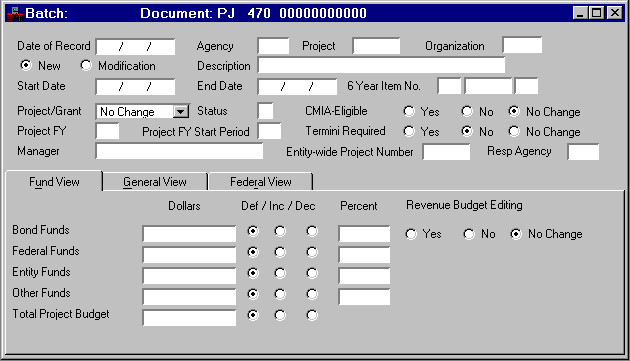

Date of Record
|
Defaults to the current date. Enter the date (
mm dd yy
) you want associated with this document, usually the current date.
|
Agency
|
Required. See Agency Index (AGCY) for valid values.
|
Project
|
Required. Enter a number to uniquely identify the project. If a new project, the project code must not exist. If modifying an existing project, the project must match the one on the original document.
|
Organization
|
Enter the Organization code for this project.
|
New/Modification [Action]
|
Defaults to
New [E]
. Select
New [E]
when entering a new project, select
Modification [M]
when modifying an existing project.
|
Description
|
Optional. Enter a brief description of the project.
|
Start Date
|
Required. Enter the beginning date (
mm dd yy
) of the project.
|
End Date
|
Required. Enter the estimated last day (
mm dd yy
) of project activity. Ensure that this date is greater than
Start Date
and is valid on Calendar Date (CLDT).
|
6 Year Item No
|
Enter the six year item number for reporting purposes.
|
Project/Grant
|
Select a valid value:
Capital Project - Line Item
Capital Project - Non-line Item
Capital Project - Force Acct
Capital Project - Emergency
Capital Project - Def Maint Pool
Captital Project w/ Contingency
Highway Project
Other Project
Grant
|
Status
|
See Project Status (PRST) for valid values.
|
CMIA-Eligible
|
Select this checkbox if the project is CMIA-Eligible.
|
Project FY
|
Required. Enter the fiscal year (
yy
) associated with this document. Enter the federal fiscal year, the state fiscal year, or any user-defined fiscal year.
|
Project FY Start Period
|
Required. Enter the calendar month (
mm
) when the fiscal year associated with this project starts. For example, if the fiscal year relevant for this project is October through September, enter
10
.
|
Termini Required
|
Optional. Select
Yes
if
Termini
must be coded on all accounting documents processed against this project.
|
Manager
|
Optional. Enter the name of the individual managing the project.
|
Entity-Wide Project Number
|
Optional. Enter the number that joins a group of projects together.
|
Resp Agency
|
Required. Enter the agency responsible for monitoring the project and for requesting federal reimbursements.
|
|
|
Bond Funds, Federal Funds,
Entity
Funds, Other Funds (Dollars)
|
Default is
0.00
. The estimated revenue resulting from one or more of the four types (bond, federal, entity, or other) of revenue associated with the project.
|
Total Project Budget (Dollars)
|
Default is
0.00
. The sum of all budgeted amounts. Line amounts must equal the amount entered in this field.
|
Bond Funds, Federal Funds,
Entity
Funds, Other Funds, Total Project Budget
(Def/Inc/Dec)
|
Default is
Default [blank]
. Enter
Increase [I]
to increase a fund amount or
Decrease [D]
to decrease a fund amount.
|
Bond Funds, Federal Funds,
Entity
Funds, Other Funds (Percent)
|
Leave blank. These fields are not used in MARS.
|
Revenue Budget Editing
|
Default is
No Change [blank]
on new entry only. Enter
Yes [Y]
or
No [N]
.
Yes [Y]
indicates that revenue budgets are used and edits are performed to ensure that funding source and revenue source amounts are synchronized.
|
|
|
Sub-Project
|
Required. Enter the sub-project(s) that identifies the division of the project. The system requires each project to have at least one sub-project.
|
Phase
|
Required. Enter the phase that identifies the division of the sub-project. The system requires each sub-project to have at least one phase. See Project Phase (PRPH) for valid values.
|
Status
|
Required. On a new transaction, select
Open [O]
or
Closed [C]
. On a modification transaction, select
No Change [blank]
,
Open [O]
, or
Closed [C]
.
|
Participating
|
Default is
No Change [blank]
. Enter
Participating [P]
if this sub-project/phase combination is associated with project activity participating in an expenditure reimbursement process. Enter
No Change [blank]
or
Non-Participating [N]
if associated costs are not eligible for participation in a reimbursement process.
|
Funds Edit
|
Default is
No Change [blank]
. Valid values are
Yes [Y]
or
No [N]
. Indicates whether project budgetary controls are applied when accounting transactions are made against the project.
|
Budget Amount
|
Default is
0.00
. Enter the amount allocated for this portion of the project.
|
Def/Inc/Dec
|
Default is
Default [blank]
. Required on modification transactions. Enter
Increase [I]
to note an increase in the budget amount or
Decrease [D]
to note a decrease.
|
Authorized Date
|
Optional. Enter the date when expenditures start incurring against the sub-project/phase combination.
|
CE Phase Percent
|
Optional. Leave blank if this is not a construction engineering phase or if the Project Billing Subsystem is not installed. Enter the percentage (
nnnnnnn
) of construction engineering costs that are eligible for reimbursement. The number you enter must be between
.001
and
100
.
|
Job Number
|
Optional. Enter the job number associated with this project/sub-project/phase if desired. Leave blank if expenditures against the project will be recorded against a fund set up with
Project/Subproject/Phase Required
selected
[Y]
on Fund (FUN2).
|
Agreement Date
|
Conditional. Required if you have installed the Project Billing Subsystem; otherwise, this field is optional. Enter the date (
mm dd yy
) when you will be reimbursed for the expenditures against this project.
|
Description
|
Optional. Enter a description of the sub-project phase.
|
Fed Prefix/Route/Section
|
Optional. Enter the applicable Federal prefix, route and section if a FHWA-funded project. For other projects, this field may be used at the agency's discretion.
|
|
|
Federal Catalog Number
|
Conditional. Required if CMIA-Eligible is selected. If entered, the first two characters must reference a federal agency on Federal Agency (FEAG).
|
Drawdown Group
|
Optional. Enter the drawdown group for this project. See Project Billing Drawdown Group (PBGR) for valid entries. The Responsible Agency must be valid for the drawdown group selected.
|
Federal Agency Name
|
Conditional. Inferred from Federal Agency (FEAG) if
Federal Catalog Number
is entered.
|
Federal Number
|
Optional. Enter the federal code that connects the grant to a federal appropriation.
|
Common Accounting Number
|
Optional. Enter a common accounting number (CAN) only if one applies.
|
Federal Identification Number
|
Optional. Enter the federal number identifying the grant.
|
Major Federal Aid Number
|
Optional. Enter the major federal aid number only if you wish the connect this grant with other grants for reference purposes.
|
Revenue Source
|
Optional. Enter a revenue source code if you wish to charge to this revenue source code instead of the revenue source code found on Project Billing Parameters (PBPT) for federal billings.
|
